Shift Design
A Shift Design defines a site's repeating roster: which Shift Types it rotates between, how many teams share the work, and the cycle they follow. Build and maintain it in the Shift Designer (Attendance workspace), a visual editor that is the intended way to work with this DocType.
1. Header and pay periods
Pick an existing design in Shift Design, or start a new one. Set the Design Name, Branch and Company, the Status (Draft, Active, Superseded or Archived), Effective From / Until, and the Cycle Anchor Date (the real date that counts as Day 1 of the cycle).
Pay Period Start Day / End Day (for example 26 to 25) and the Ordinary Hours Limit (for example 195) are used by the Site Budget and Monthly Attendance to split time and cost into pay periods and to work out overtime.

2. Shift Types and pattern generation

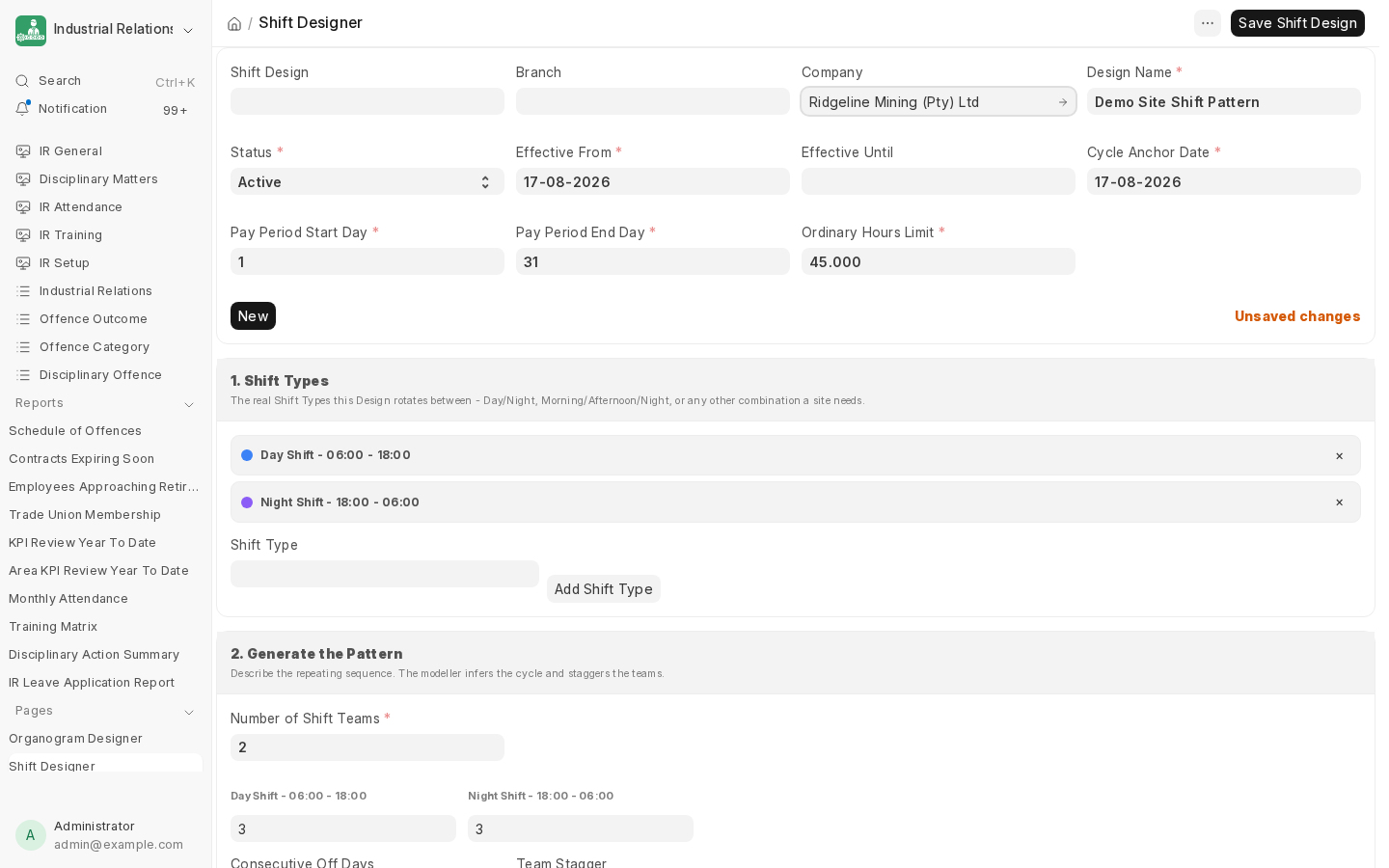

Add the real HRMS Shift Types the design rotates between, with the weekdays each applies on. Then describe the sequence and let the modeller build it:
- Number of Shift Teams
- how many consecutive days of each Shift Type, and Consecutive Off Days
- Team Stagger (for example Evenly Stagger)
Click Generate Pattern. The summary shows the team cycle length, enabled teams, how often the whole operation repeats, and whether it aligns to whole weeks. Add Cycle Day / Remove Cycle Day adjust the cycle by hand.

3. Visual Cycle Editor
The generated cycle appears as a grid of teams by cycle day. Click a cell to cycle it through the Shift Types and Off, or drag a Shift Type chip onto a cell.

4. Calendar rules and date overrides
Calendar Rules special-case public holidays or particular weekdays, for example "on public holidays, follow the pattern" or "on Sunday, only the team on Day continues". Each rule has an action, an optional target Shift Type, an hours override, a priority and an enabled flag. Date Overrides change the assignment for one team on one date, with a reason.
5. Calendar simulation
Set Simulation Start / End and click Recalculate Simulation to expand the cycle over real dates. Public holidays from the company's holiday list are highlighted, so you can check coverage before the design goes live.

Save with Save Shift Design. A Shift Design isn't tied to one site plan: Site Plans reference it for their shift columns, and several plans can share the same design. The designer's menu also offers Export Excel.
Next: Site Plan Designer.
